Installing a heating system is only part of the job. The installation isn't complete — and you can't hand it over to the customer — until you've commissioned it properly, tested it for soundness, flushed it through, balanced it, and checked it performs as designed. Once the system is in service, you'll also spend a good proportion of your working life diagnosing faults on systems that someone else (or you) installed years ago.

This post covers both ends — commissioning a new system, and finding faults on an existing one. It's the final deep-dive in the Level 2 heating sub-cluster. For the others, see the system types, boilers, controls, system layouts, and open-vented vs sealed posts.

The five stages of commissioning

The workbook sets out commissioning as five sequential stages:

  1. Visual Inspection
  2. Soundness Testing
  3. Flushing and Disinfecting
  4. Performance Testing
  5. Final Checks and Handing Over

Each stage has to be completed before you move on to the next. Skipping ahead — for example, trying to pressure test without checking for open ends first — is how jobs go wrong. Learn the order: visual → sound → flush → perform → hand over.

Stage 1: Visual Inspection

Before you fill anything with water, walk round the installation and check it by eye.

What you're looking for:

Once the visual inspection is complete, fill the system with water and check again for obvious leaks before starting soundness testing.

Stage 2: Soundness Testing — rigid pipe

Soundness testing is a pressure test that confirms the pipework can hold more than its normal working pressure without leaking. There are two different procedures — one for rigid pipe (copper, LCS, stainless steel), one for plastic.

Hand-operated hydraulic test pump used to pressurise heating pipework for a soundness test

Rigid pipe soundness test procedure:

  1. Visually check the pipework — are there any open ends? If yes, cap them off before proceeding.
  2. Fill the system with wholesome water and leave for 30 minutes so the temperature can stabilise. Check for leaks.
  3. Using a hydraulic pump, pressurise the system to 1.5× the maximum working pressure. Check for leaks again.
  4. Leave the pipework on test at 1.5× working pressure for 1 hour.
  5. Check whether there has been any pressure drop. If yes, find and fix the leak, restart the test from the fill-with-water stage.
  6. If no pressure drop, complete the paperwork and move on to flushing.

Worked examples:

If you find a leak at any stage, stop the test, fix the leak, and restart — don't try to patch and continue.

Stage 2 (continued): Soundness Testing — plastic pipe

Plastic pipe (polybutylene, MDPE) is more elastic than rigid pipe, so plastic tests allow for some pressure drop as the pipe stretches under test. There are two procedures — Test A and Test B.

Test A (timed rigid-then-drop test):

  1. Visual check for open ends.
  2. Fill with wholesome water to 1 bar, leave for 45 minutes, check for leaks.
  3. Pressurise to 1.5× working pressure using a hydraulic pump, check for leaks.
  4. Leave at 1.5× working pressure for 15 minutes.
  5. Drop to 1/3 of working pressure and leave for 45 minutes.
  6. Check for pressure drop — if yes, fix leaks and restart.
  7. If pass, move on to flushing.

Test B (extended pressure observation):

  1. Visual check for open ends.
  2. Fill with wholesome water, visual check for leaks.
  3. Pressurise to 1.5× working pressure, check for leaks.
  4. Top up to maintain 1.5× working pressure for 30 minutes (allowing for pipe expansion).
  5. Note the pressure and check again 30 minutes later — if the drop is more than 0.6 bar, the test fails.
  6. If acceptable, note the pressure and leave for 120 minutes — drop of more than 0.2 bar is a fail.
  7. If pass, move on to flushing.

For both plastic tests, the principle is the same: plastic allows some elastic give, so you're testing both initial soundness and stability over time.

Stage 3: Flushing and Disinfecting

Flushing removes debris, flux residues, and manufacturing lubricants from the pipework before the system goes into service.

Domestic flushing:

Commercial or industrial flushing:

Corrosion inhibitor:

Stage 4: Performance Testing

Performance testing checks that the system actually works as designed under real operating conditions.

What to check:

Tools for performance testing:

Performance testing also includes balancing the radiators. On a two-pipe system, that means adjusting the lockshield valves so each radiator heats up at roughly the same rate — with the furthest radiators' lockshields fully open and the closest ones gradually closed down.

Stage 5: Final Checks and Handing Over

The last stage is about leaving the customer with a working system and the paperwork they need to maintain it.

Radiator bleed key used to release trapped air from radiators after filling and venting the system

What to hand over:

Worthwhile additions (from the workbook):

Common faults and how to diagnose them

A good chunk of your working life will be spent on fault-finding. The workbook covers a set of common faults with characteristic symptoms — learn these and you'll diagnose most basic issues by ear before you even take anything apart.

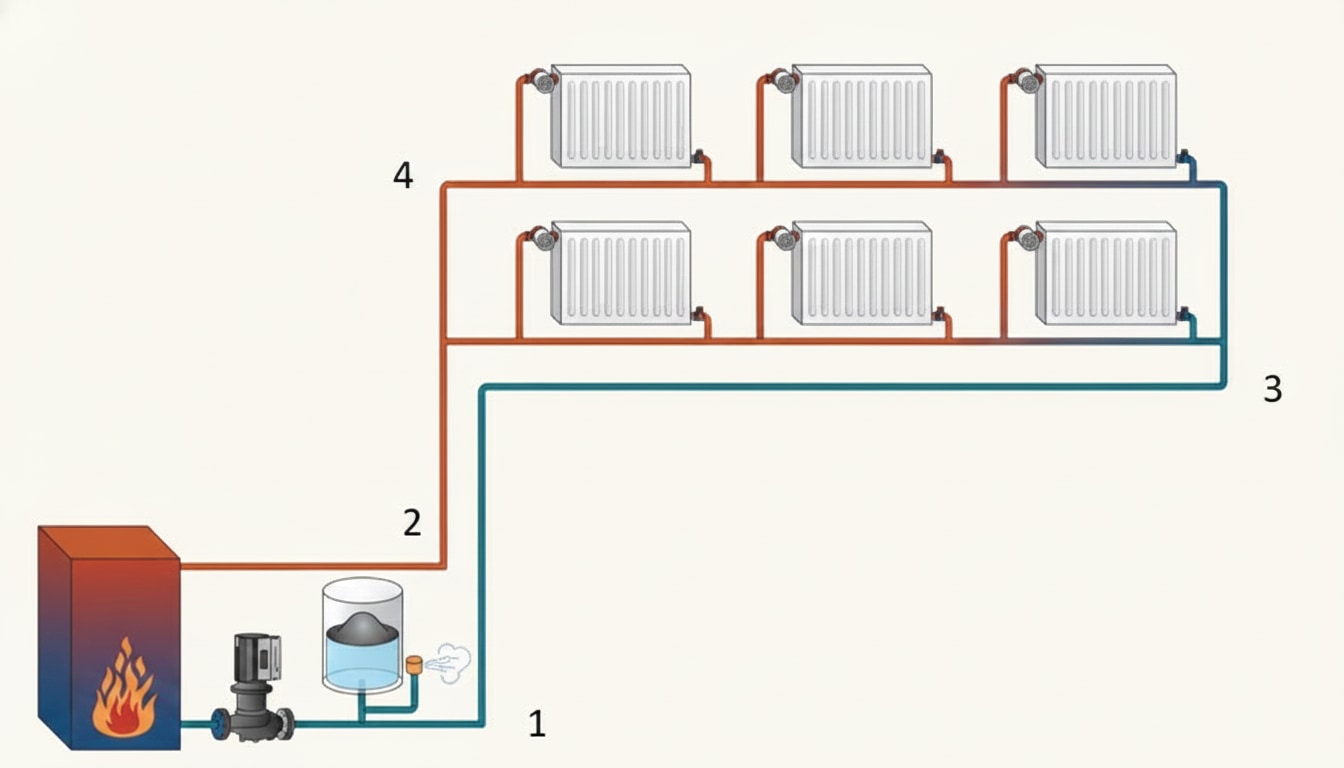

Drain-off valve positions on a central heating system showing where to drain different sections of the circuit

Pump humming. Damaged pump, most likely needs replacing.

Knocking from pipework when the system fires up. Unclipped or loosely clipped pipework — remedy by clipping properly at appropriate centres. Don't clip too tightly (see next fault).

Ticking sound as the system heats up. Pipework clipped too tightly to wood. Thermal expansion causes the pipe to lengthen and slip past the clip under friction. Fix: slip a small piece of felt between the pipe and the wood to reduce friction.

Bubbling, gurgling, or splashing sounds. Air in the system. Bleed the radiators and install automatic air release valves at high points to prevent recurrence.

Radiators lukewarm upstairs, cold downstairs. Classic sign of pump failure. The boiler is firing and the hot water is drifting up through the system by convection alone — which reaches the upstairs radiators weakly but never forces water down to the downstairs radiators.

System constantly on / boiler firing when nothing's called for. Most likely cause is a faulty programmer, but also check for a motorised valve stuck open — the live connection in the motor causes the boiler and pump to stay on continuously. A valve stuck closed gives the opposite symptom: no heat anywhere.

Radiator warm at the bottom but cold at the top. The radiator needs bleeding — air has collected at the top and is blocking hot water from reaching the upper section.

Radiator warm at the top but cold at the bottom. The radiator needs flushing — sludge has built up at the bottom, blocking hot water flow. Sludge is typically corrosion debris from ferrous components and is minimised by keeping the inhibitor level topped up.

Decommissioning: temporary and permanent

Related to commissioning but the opposite direction. Two types:

Temporary decommissioning — taking the system out of service for maintenance or repair, knowing it'll be put back into use.

Key points:

Permanent decommissioning — taking a system out permanently.

Key points:

Replacing a radiator like-for-like:

Common exam traps

Trap 1: Order of commissioning stages. Visual → Soundness → Flushing → Performance → Handover. Questions test whether you know the order.

Trap 2: Soundness test pressure. 1.5× working pressure for both rigid and plastic pipe. Not 2×, not the working pressure, not ½×. Any other figure is a distractor.

Trap 3: Inhibitor timing. Corrosion inhibitor is added after flushing, not before. Before would just be flushed away.

Trap 4: Radiator cold at top vs cold at bottom. Cold at top = bleed (air). Cold at bottom = flush (sludge). Get these the wrong way round and you'll attack the wrong problem.

Trap 5: Flushing fluid. Domestic = wholesome water. Commercial = chlorine-based (COSHH applies, inform water undertaker). Don't assume chemical disinfection is needed on every job — it's a commercial-only step.

Quick revision summary

Before the mock test, seven things you need to be able to produce from memory:

  1. Five commissioning stages in order: Visual → Soundness → Flushing → Performance → Handover
  2. Rigid pipe soundness test: fill with wholesome water, 30 min stabilise, pressurise to 1.5× working pressure, 1 hour test, check for drop
  3. Flushing: domestic = wholesome water; commercial = chlorine (COSHH); heating systems get inhibitor after flushing
  4. Performance testing tools: pressure gauge and Weir cup
  5. Radiator cold at top = bleed; cold at bottom = flush
  6. Lukewarm upstairs, cold downstairs = pump failure
  7. Permanent decommissioning: cap pipe as far back as possible to prevent stagnation
